This document provides essential installation and setup procedures for the Bryant 215S Single Stage Heat Pump. Before beginning, ensure all safety codes are followed, including wearing protective gear. The unit must be installed by a qualified professional. Key steps include proper unit location, secure mounting, correct refrigerant piping, and accurate electrical wiring. Always verify the system charge using the subcooling or superheat methods as specified in the manual.
Installation Recommendations
Proper installation is critical to prevent noise and ensure efficiency:
- Locate the unit away from windows, patios, and decks to minimize noise disturbance.
- Ensure vapor and liquid tube diameters are appropriate for the unit capacity.
- Run refrigerant tubes as directly as possible, avoiding unnecessary turns.
- Leave slack in tubing to absorb vibration and avoid contact with water pipes or ductwork.
- Use hanger straps that are 1 inch wide and conform to the shape of the tubing insulation.
Mounting and Clearance
The unit must be installed on a solid, level mounting pad. If local codes require, use tie-down bolts through the base pan knockouts. For rooftop applications, mount on a level platform above a load-bearing wall. Maintain the following clearances for proper airflow and service:

- Service end: 24 inches.
- Above unit: 48 inches.
- Sides: 6 inches on one side, 12 inches on all remaining sides.
- Between units: 24 inches (or 18 inches if no overhang within 12 feet).
Piping Connections
Outdoor units are shipped with a refrigerant charge sealed in the unit. Keep service valves closed until all piping work is complete. When brazing, wrap service valves with a wet cloth to prevent heat damage. Use refrigerant-grade tubing and ensure the system is evacuated to 500 microns before opening service valves.

Electrical Connections
Ensure field wiring complies with local and national electrical codes. Use copper wire only between the disconnect switch and the unit. Route control wires through the grommet and connect to the control wiring. For 3-phase units, a monitor control is provided to indicate phase status.

Start-Up and Charging

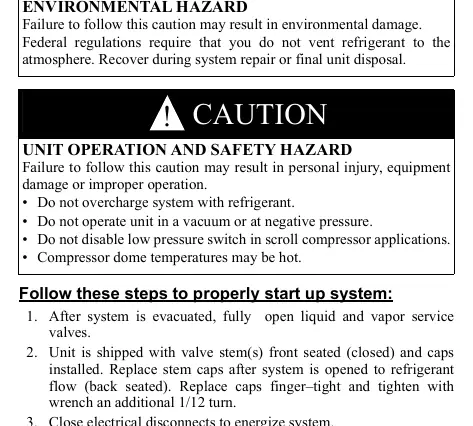

After evacuation, open the liquid and vapor service valves. Set the thermostat to the desired temperature and operate the unit for at least 15 minutes before checking the charge. Use the subcooling method for units with a TXV and the superheat method for units with indoor pistons. Refer to the provided tables in the manual for specific temperature and pressure values.
Defrost Control
The unit features a time/temperature defrost control. The 'Quiet Shift-2' mode is a field-selectable option (factory set to OFF) that reduces noise during defrost cycle transitions. It can be enabled by setting DIP switch 3 on the defrost board to the ON position.

Practical help
Common problems
Ensure unit is located away from windows/decks and tubing is isolated from structure.
Use subcooling method for TXV or superheat method for piston systems as described in the manual.
Enable 'Quiet Shift-2' by setting DIP switch 3 on the defrost board to the ON position.
Indicates reversed phase. Check power supply wiring.
Before use
- Verify unit is level within ±2°
- Check clearance requirements (24 in. service end, 48 in. above)
- Ensure refrigerant tubing is clean and properly sized
- Confirm electrical voltage matches rating plate
- Ensure factory-supplied liquid-line filter drier is installed
Show more Show less
Specs in practice
- Quiet Shift-2
- Defrost mode that reduces noise during cycle transitions.
Images and diagrams
- Fig 1: Shows proper tubing installation through walls and suspension.
- Fig 2: Details tiedown knockout locations on the base pan.
- Fig 8: Illustrates line connections to the contactor.

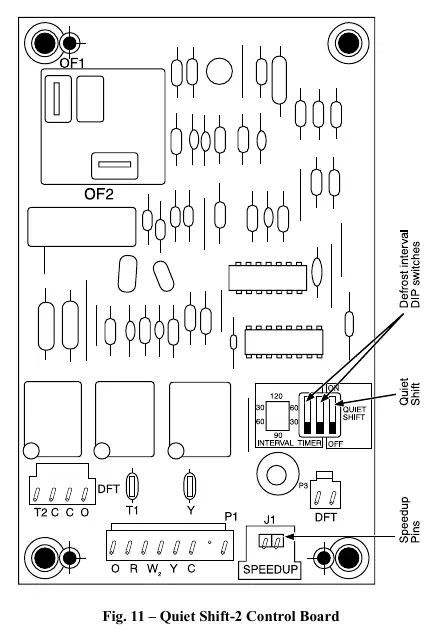

- Fig 11: Shows the Quiet Shift-2 control board and DIP switch settings.
Model compatibility
- Maximum liquid-line size is 3/8-in. OD for all residential applications.
- Do not use soft solder (materials melting below 800°F/427°C) for brazing.
- Units with louver panels require 24 inches between units.
